Enterprise climate platform, B2B web
Target Validation Platform
I cut a regulated climate-target submission from 14 steps to 6, without removing a compliance checkpoint.
- Role
- Senior Product Designer, sole designer on the flow
- Team
- Product, engineering and climate policy, 3 squads
- Timeline
- 5 months
- Platform
- Enterprise web

Product screens shown with permission. Some details are simplified under NDA.
01Discover

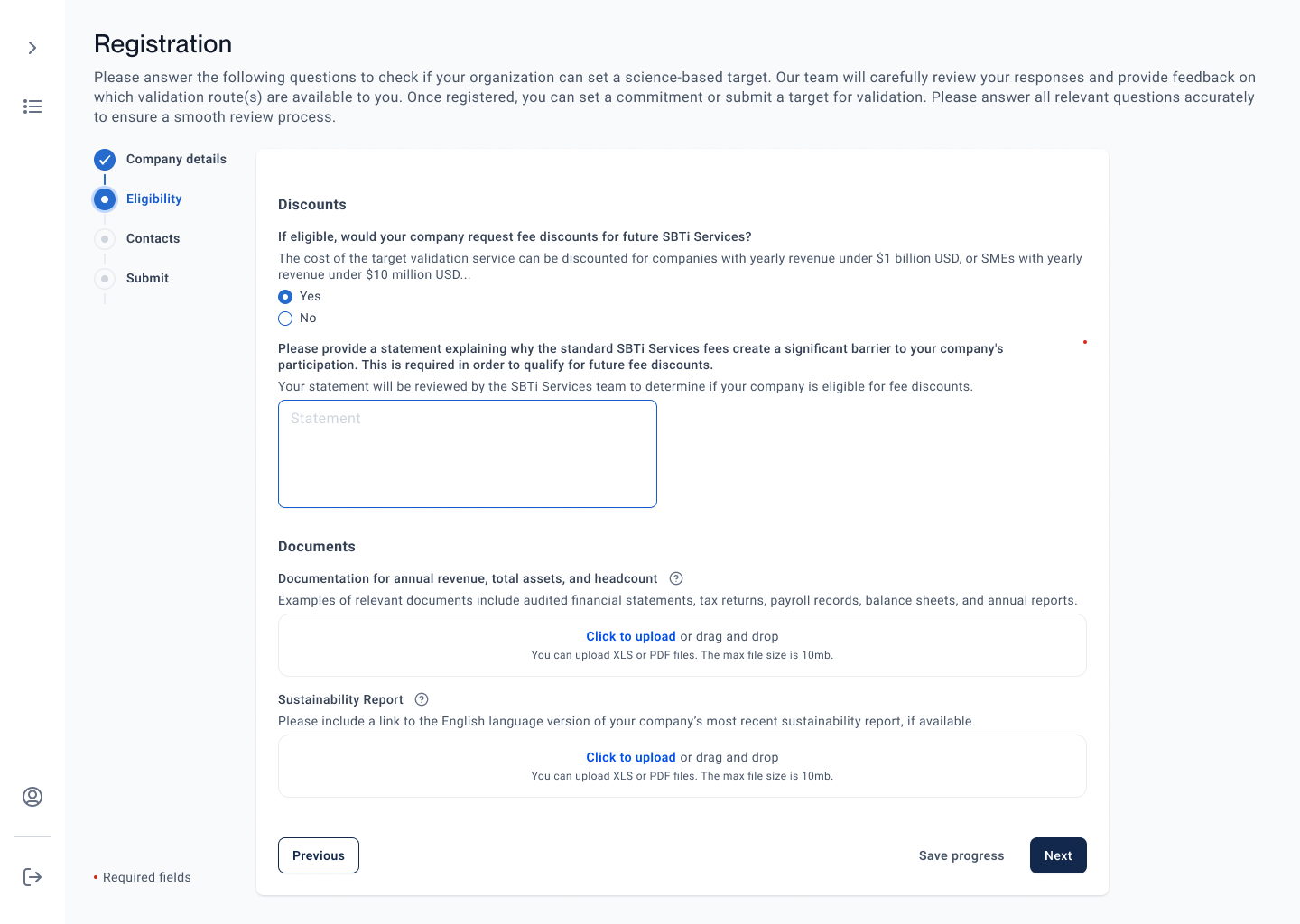

A multi-session task built as a one-shot form
Sustainability teams submit their company's climate targets here. The flow was 14 rigid steps with no saving, and requirements surfaced only as errors. The result: a 67% abandon rate and a 4.5-hour median completion time. A previous redesign had stalled because product, engineering and policy disagreed on which steps the law required.
- Interviews, n=16Sustainability managers, analysts and regulatory leads across energy, finance, manufacturing and tech. People understood the data but lost their place.
- Task analysis, n=8Observed real submissions. The common workaround was a spreadsheet kept alongside the platform to track progress.
- Policy auditEach of the 14 steps put to policy specialists as a claim to check, not an opinion to argue. 8 were legacy, not law.
- Stakeholder workshopsAssumption-testing sessions with product, engineering and policy.
Sustainability manager, owns getting the submission complete and on time
Submits the company's climate target for validation. The work runs across several sessions and depends on data from analysts.
Know what is required up front, see progress, and trust that work already entered is kept
- Six steps instead of fourteen, after the policy audit
- A persistent step bar with position and estimated time
- Auto-save every 30 seconds; resume where they left off
- The step bar becomes the record of progress
- Inline validation as they work
02Define
Orientation, not comprehension
The tempting diagnosis was that the data was too hard, so ask for less. Research did not support it. The spreadsheets were a workaround for progress tracking, which the product did not have.
Submission owners need to stop and resume a long, regulated task without losing their place or their work, because the platform treats a multi-session job as a one-shot form.
Three roles, one workflow
- Submission ownerGets the submission complete and on time. Blocked by no saving and late requirements.
- Data providerSupplies accurate documents and scope. Blocked by rigid input formats and no inline guidance.
- ReviewerReviews dozens of submissions a quarter. Blocked by manual status tracking.
Success chain, set before the rebuild
- LeverRemove the steps that are not legal requirements.
- EnablerMake a long task survivable: progress, saving, confirmation.
- User outcomeFewer people give up partway.
- Business outcomeMore submissions completed, less load on support.
03Ideate
Two directions turned down
Design for all three roles
The reviewer is why a submission completes at all. More screens and a longer build.
Optimise for the owner only
Cleaner and faster to build, but it moves the bottleneck to manual review.
The AI recommends, the person decides
Scope analysis over unstructured documents shows its confidence and source, and can be overridden.
Let the AI fill the step
Demos better and saves more time. A company answers for this submission publicly.
The converged flow: six steps, a persistent step bar with position and estimated time, auto-save every 30 seconds, and inline validation on each step.
04Prototype & test
Moderated testing with eight enterprise users
Reviewers would not accept a recommendation they could not audit. Trust was the lowest finding, 3.8 of 5.
The recommendation shows its source, explains its reasoning and offers an override, so the decision stays with the accountable person.
Through build I stayed with all three squads. Specs marked fixed compliance checkpoints on the screen they affected, and the flow shipped in pieces sequenced by migration risk, so no regulated submission was left half-migrated.

05Outcome
Measured in production, quarter before vs after
A regulatory deadline fell in the launch quarter, so abandon rate, tickets and engagement are directional. Step count and completion time are attributable. After launch I redesigned the target dashboard from funnel behaviour and the support queue.
In a regulated task, certainty matters more than speed. Progress and auto-save moved completion more than any change to the fields.
